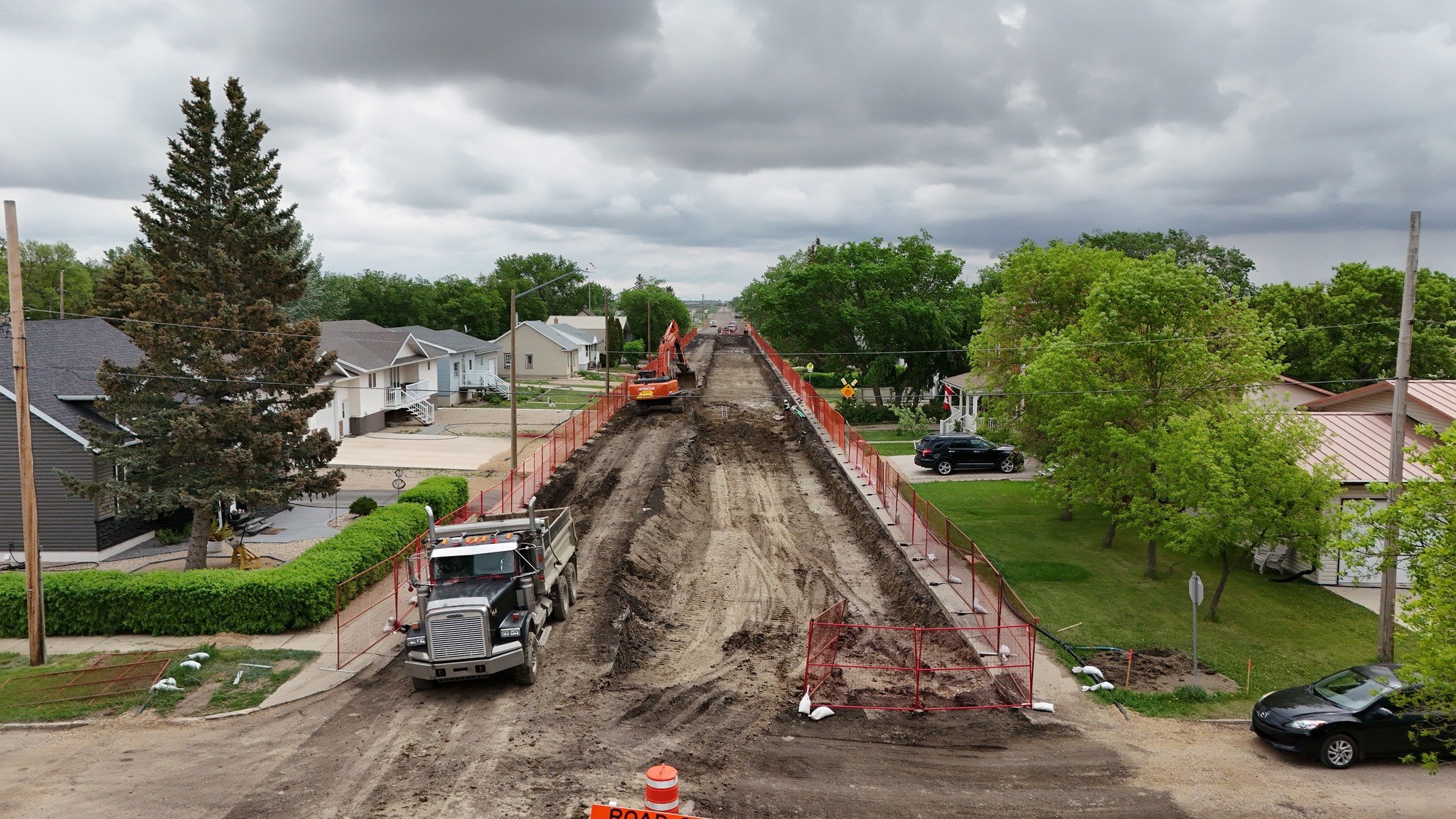

The Town of Gravelbourg will undergo a significant infrastructure improvement project beginning with the decommissioning and dismantling of the 1928 water tower in August 2024. The project scope includes the replacement of the watermains on 1st Avenue, Main St, Bettez St, and 7th Avenue with completion expected by the end of 2026.

Residents and visitors can expect intermittent disruption to services and road access. We encourage those affected to sign up for Citizens Alert and monitor this page for updates. Thank you for your patience and understanding as we embark on this major update to our water infrastructure that will improve and secure services for generations.

Updates

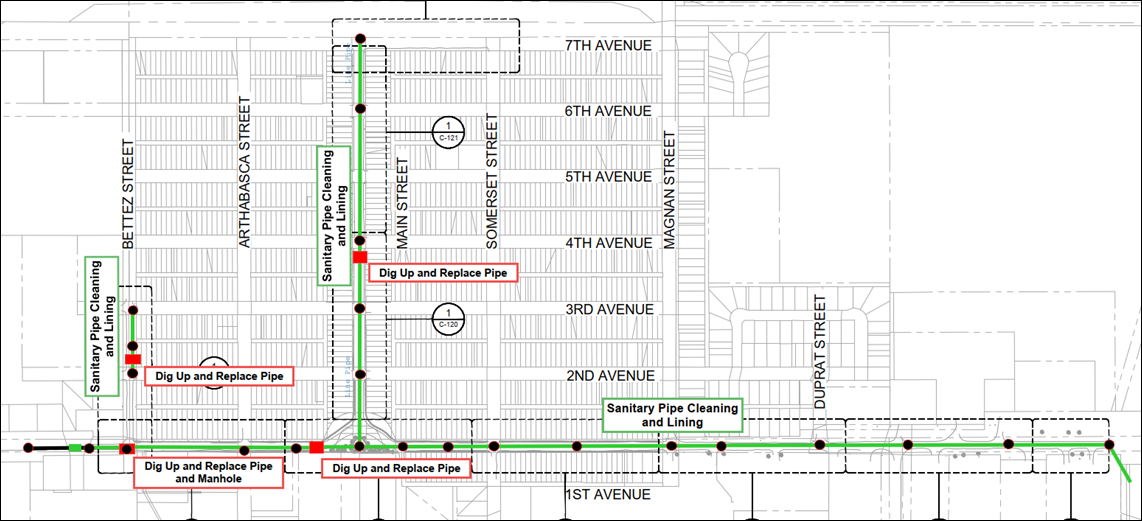

October 15, 2025:  As part of the Town’s preparations for the Water Main Replacement Project, early work is underway this week (October 15–21), including sewer cleaning and four spot repairs. Here's what to expect:

Repair Schedule & Locations:
Oct 15–16: Main St & 4th St
Oct 16–17: 1st Ave
Oct 18–19: 1st Ave & Bettez St
Oct 20–21: Bettez St

✅ No disruption to water or sewer services
✅ Minor traffic impacts near repair sites
✅ Roads will be temporarily restored with cold mix asphalt for winter

📣 Want to learn more?
The first of two planned information sessions is geared towards residents and businesses on 1st Avenue, Main St, and Bettez, and will focus on the project scope, impact, and schedules.

🗓️ Water/Sewer Project Info Session
📍 Monday, October 20, 2025
🕖 7:00 PM
📌 Parish Hall (114 1st Ave W)

Meet the experts from Associated Engineering and Bullin Construction, ask questions, and learn how this project will benefit our community for years to come.


September 11, 2024: Crane is travelling to Gravelbourg on Friday, September 13. Bowl lifting day & tower dismantling scheduled for Saturday, September 14 and Sunday, September 15 (if required). All work on the tower is subject to weather.

August 29, 2024: Due to weather delays and equipment availability, the dismantaling of the water tower has been postponed. Please continue to monitor this page for updates.

August 26, 2024: Due to forcasted winds/wind gusts in excess of 30km/hour, the dismantling of the water tower is now tentatively scheduled to begin on Friday, August 30 (weather permitting).

August 15, 2024: Project start date has been pushed to August 22; Priestly Demolition Inc. will commence with fencing, tank drainage and tank preparation. Tank lifting day is scheduled for August 27 (weather permitting).



Documents

The Town of Gravelbourg thanks the Governments of Canada and Saskatchewan for their contribution to this project. For more information, please consult the links below or contact the Town:
