Given the nature of infrastructure repair and the Saskatchewan climate, please note that these schedules are subject to change. The 2026 work is scheduled for 1st Avenue East only. Residents and visitors can expect some adjustments to traffic flow. For planned detour routes, visit the Traffic Plans page. 1st Avenue East residents and businesses should expect minimal disruption to water service. 1st Avenue businesses will remain accessible.
Bullin Construction Water Main Replacement Full Project Schedule (as of March 2026)
September 2026 UPDATES
Traffic & Access
- Sept 2 — Traffic accommodations switch to detour through Duprat.
- West entrance to Colledge remains open.
- Sept 10 — Colledge entrance switches to the east entrance, which will remain in place until sub‑base/base is installed to the end of Somerset.
Earthworks & Subgrade/Sub‑base
- Sept 2–10
- Excavation from Duprat to Colledge tie‑in for subgrade preparation.
- Excavation from 90 to Colledge tie‑in, continuing toward Magnum.
- By Sept 30 — Sub‑base installed to Somerset.
Water & Sewer Infrastructure
- Install pipe and connect services between Magnum and Somerset.
- Perform pressure testing, chlorination, and commissioning.
- Backfill 1 m above storm height.
- Install storm system.
- Connect new water main.
- Turn newly installed services on to each property.
- Remove temporary water and complete cleanup.
Paving
- Second week of October — Paving begins, targeting October 12.

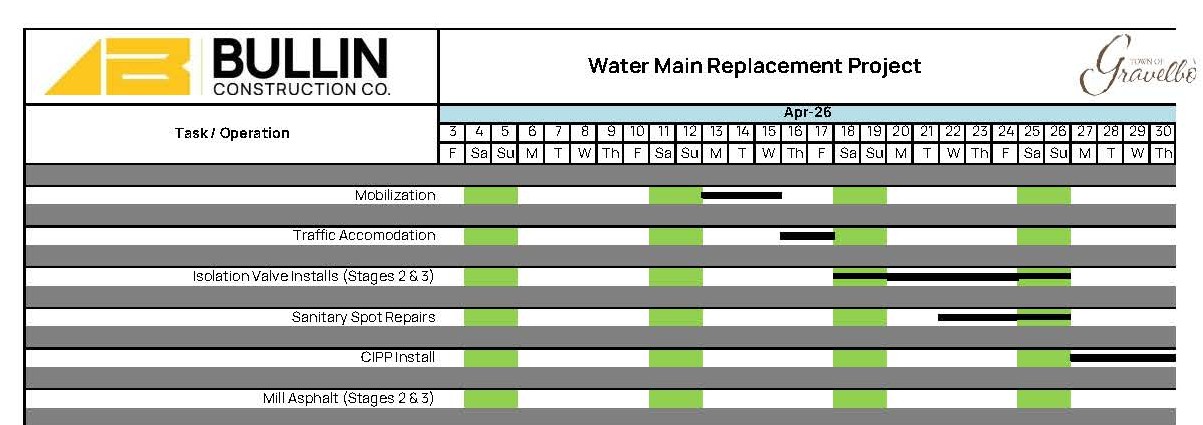

April 2026

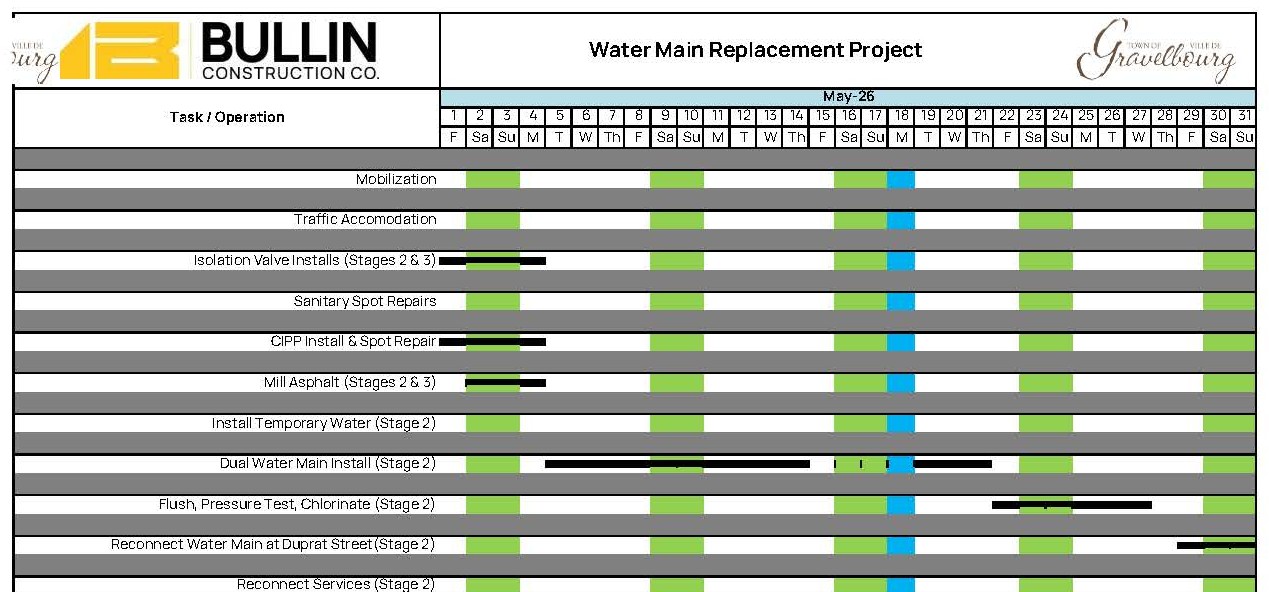

May

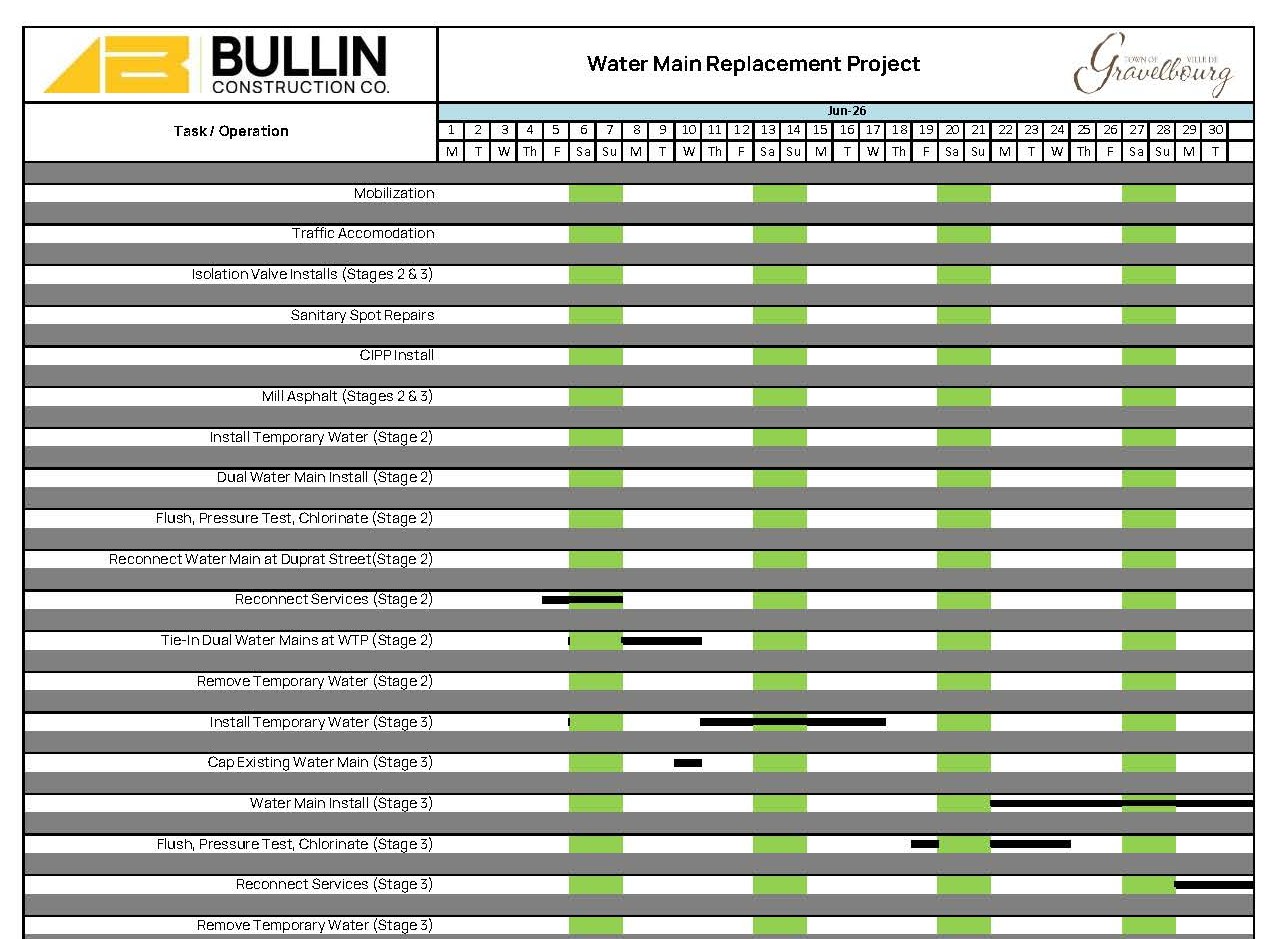

June

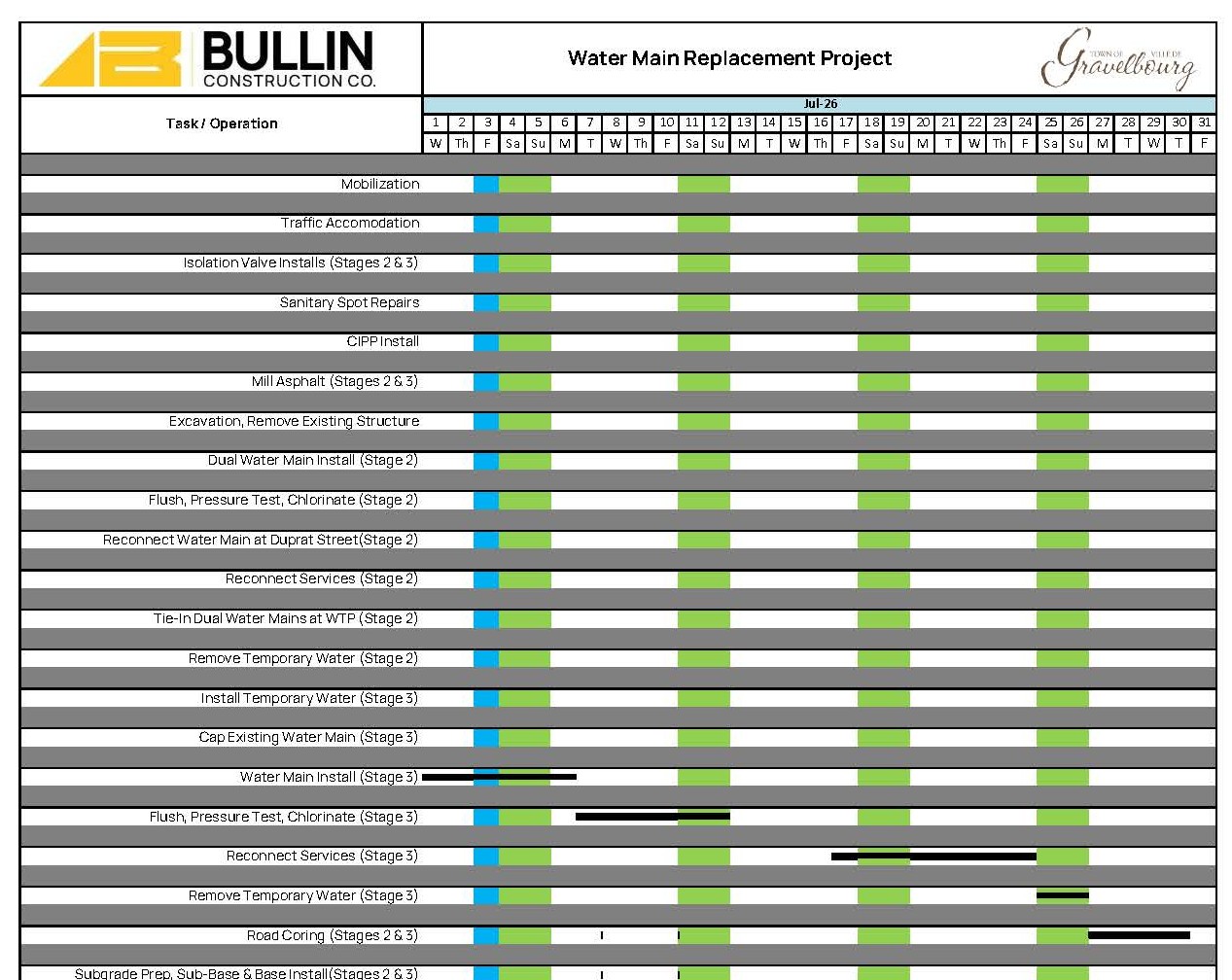

July
